Migration Activity ( CX-4.7 to CX-4.8 )
How to Proceed
From the
data_migration_config.yaml
, set the followingmongodb credentials (
host, port, username, password, tls
)start_date
andend_date
as per the duration you want to run migration (details mentioned in Configurations)For this demonstration, we have set the
start_date
andend_date
to be “2025-01-08” to “2025-03-09”, and theinterval
to 360 (6 hours)
It is noted that whenever the start_date
and end_date
are updated in the yaml file, the config map ef-transflux-config-cm
is re-created and the activity will resume from here
On airflow UI, within the Conversation_Migration -> Details, you should see the start and end date as set within the config from Figure 1, in the bottom. Make sure the pipeline is paused initially

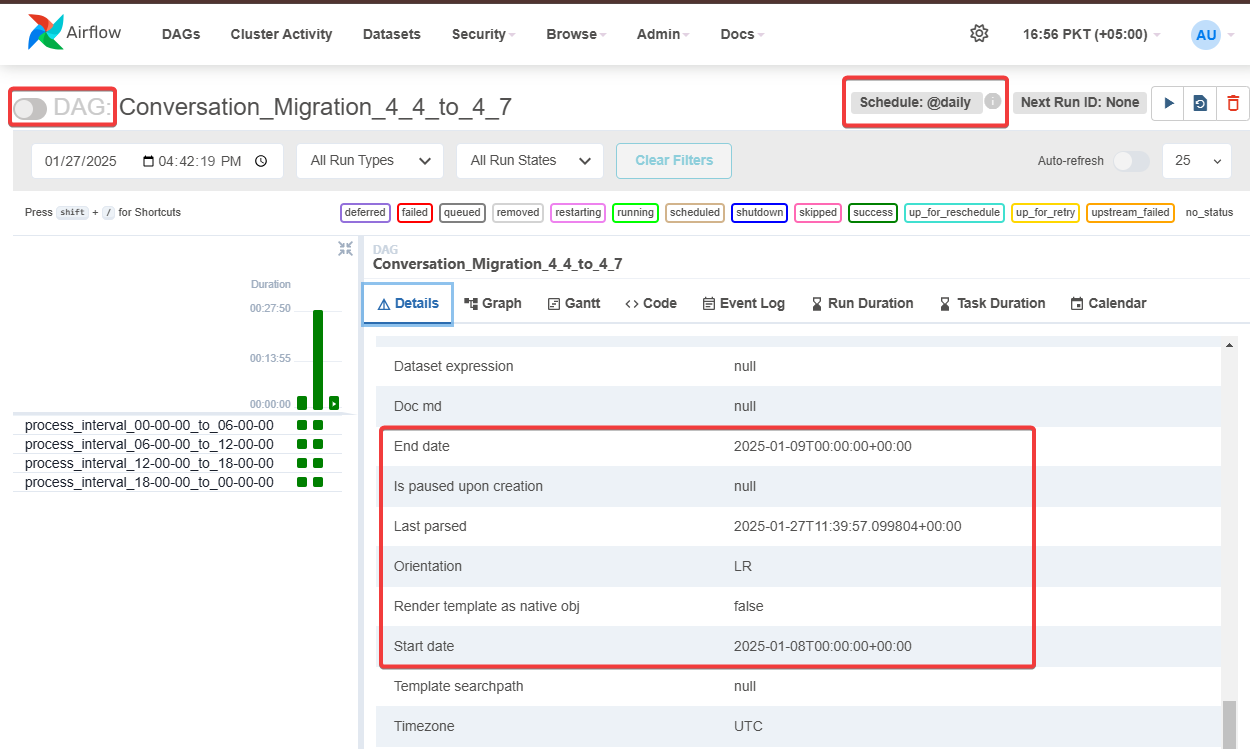

Figure 1. Airflow UI of the conversations migration pipeline, highlighting start and end date, schedule and pause/un-pause button
If there are existing pipeline runs available (Green bars, to the right of figure 1.) and this is your first time running the pipeline after adjusting the configuration, then
Click on Schedule (Refer to Figure 1), you will see all the instances ran, select all of them and delete from actions button (Refer to Figure 2.)

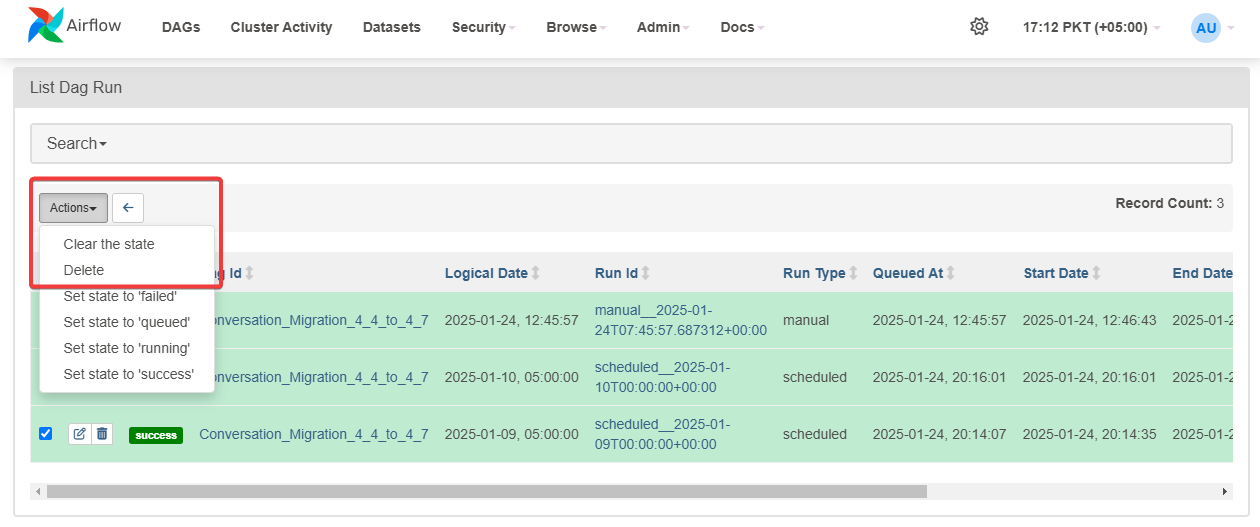

Figure 2. Deleting the existing pipeline runs for the initial runs
Go back to the Conversation_Migration pipeline, now you will see there will be no runs available (green bars) and the next RUN ID (next to the schedule in figure 1.) is set to the
start_date

as configured in the yaml file (Refresh the tab till the changes reflects)Switch to Graph, next to Details tab (Refer to figure 1.) to see the graphical view, this will show you the interval wise task as set within the config file
Resume the pipeline and refresh the window,/tab you will see the tasks running in the graphical view section. Make sure to turn on the auto-refresh to keep seeing the most recent state.
As the pipeline runs, there are few things that need to be observed (Refer to Figure 3.)
pipeline instance: To check whether the task instance of the specific date has run successfully (Left green bars), the square boxes highlights the task of that interval and vertical bar highlights the overall state of that pipeline instance of that date
Run Date: The date on which pipeline instance has been launched and completed.

Figure 3. Highlighting the pipeline instance, Run date
Rollback Plan
If for some reason, the data didn’t come for a specific interval, (lets say from 06:00:00 to 12:00:00 of 2025-01-09). and we want to execute that interval again,
Click on the small green square (Refer to figure 3.) of that interval and select “Clear task”. This will open a new dialogue, select the “Recursive” option and then Clear (Refer to figure 4). This will clear up that task at that interval and queue it up for re-run

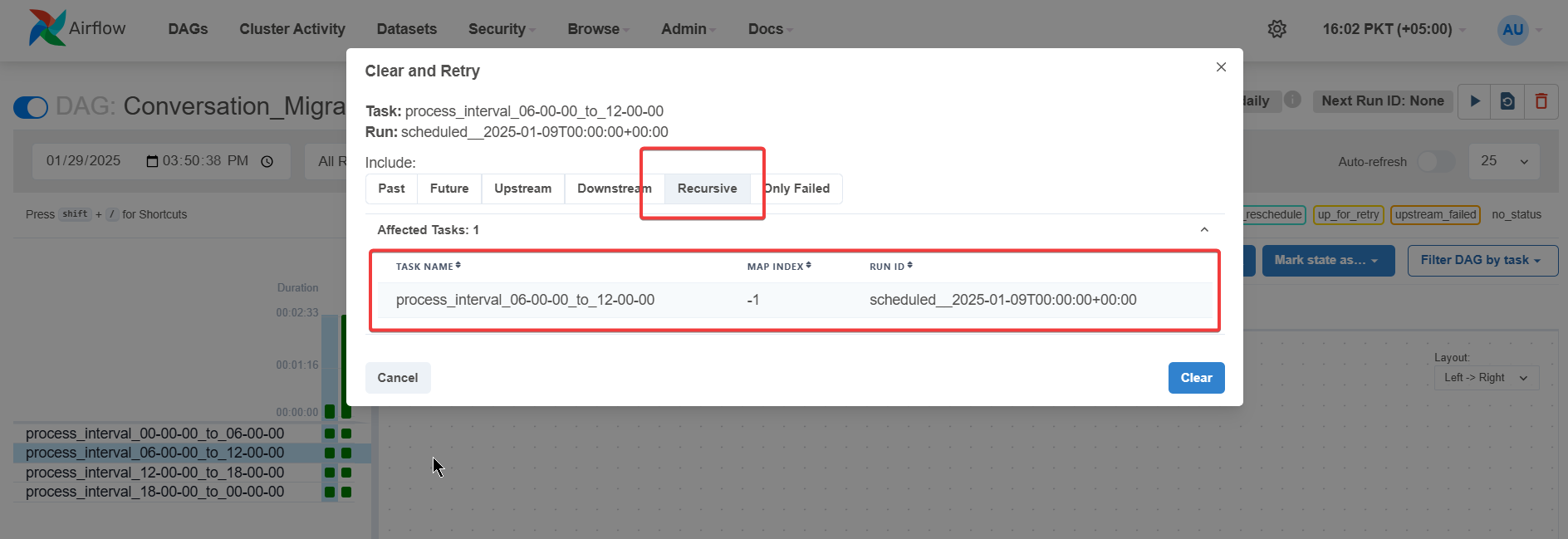

Figure 4. Highlighting the task re-run dialogue when Clear Task button is pressed
If we want to re-run for the entire day (lets say for 2025-01-08),

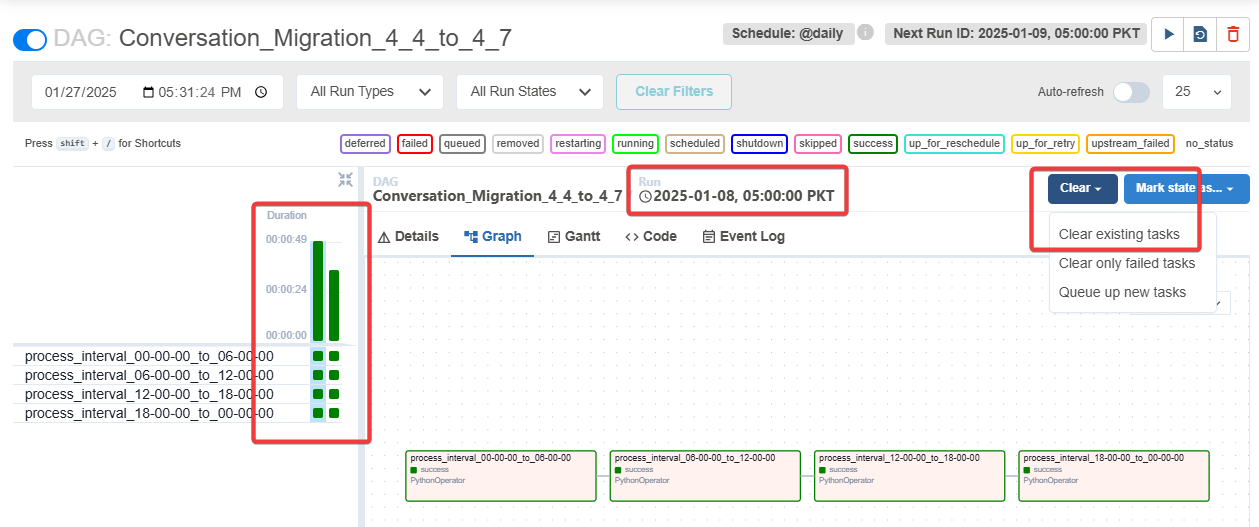

Click on the vertical bar at that time, then Clear → Clear existing tasks, this will re-run the entire instance on that date (Refer to figure 5.), refresh the tab if necessary.
It is recommended to pause the pipeline while clearing states to synchronize the schedule with the latest state.

Figure 5. Highlighting the pipeline instance, clearing up the runs of that instance
